Home Renovation & Addition Inspections in BC

Scheduling inspections for an existing residential renovation or room addition requires knowing exactly which municipal checks apply. While an interior remodel or suite legalization skips excavation and rain screen checks, a footprint addition requires foundation tie-in sign-offs and setback surveys. Here is your in-depth guide to passing every renovation inspection stage across British Columbia.

Renovation & Addition Inspection Schedule

Chronological inspection schedule detailing when each trade check occurs and whether it applies to interior remodels, suite legalizations, or room additions.

Stage & TradeWhen to CallWhat Is Checked
1. Excavation & Footings
Additions Only
Prior to pouring new concrete footings for room addition.Native soil bearing capacity, rebar layout, and foundation rebar dowel tie-ins into existing concrete.
2. Foundation Forms & Survey
Additions Only
Forms erected with rebar, prior to pouring new foundation walls.Anchor bolts, wall forms, and certified BCLS Survey proving addition respects setback bylaws.
3. Perimeter Drain Tile
Additions Only
4″ perforated pipe laid with washed crushed rock, prior to backfill.Perimeter weeping tile tied into existing storm system, damp-proofing on new foundation.

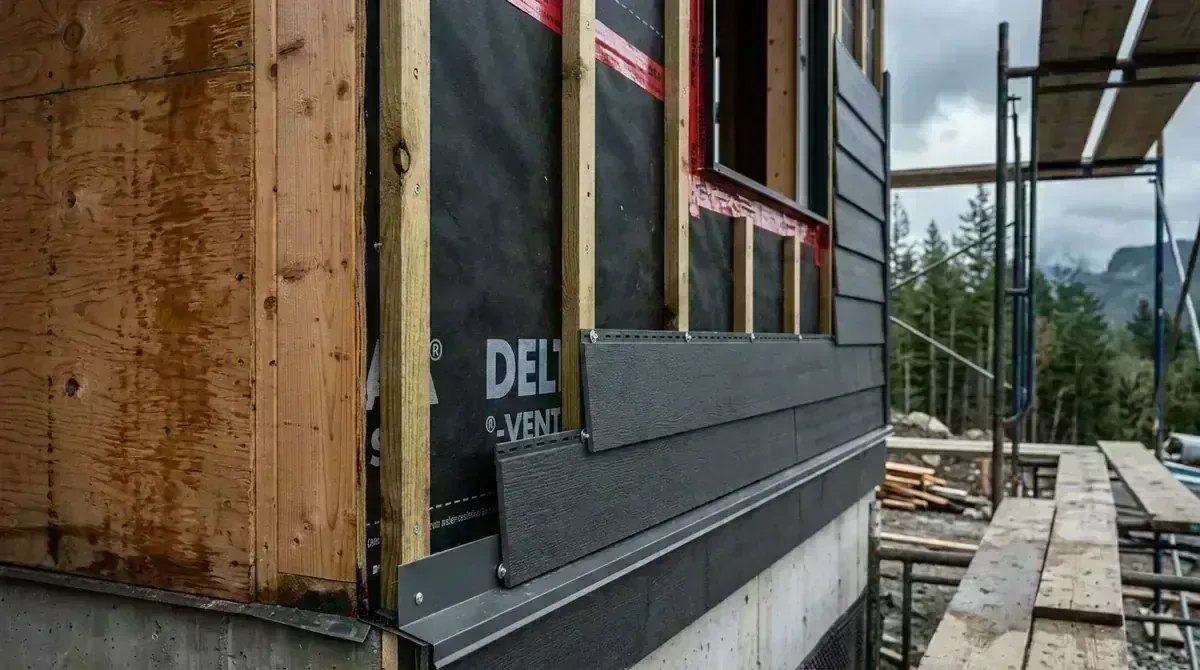

4. Rain Screen & Flashing
Additions / Exterior Work
House wrap, furring strapping, and window mockups complete.10mm drainage cavity, sill pan flashings, self-adhered membrane, and bug screens.
5. Plumbing Rough-In
All Renos & Suites
Drainage and water supply pipes installed, prior to framing call.DWV system under 10-ft head water pressure test or 5 PSI air test, supply lines under pressure.
6. Electrical Rough-In
Technical Safety BC / City
Wiring pulled and boxes mounted, prior to insulation.Arc fault breakers, box fill, dedicated circuits, and interconnected smoke detector feeds.
7. Structural Framing
All Renos & Additions
Rough-ins passed and roof watertight, prior to insulation.Load-bearing beam sizing (LVL/steel), post point loads to ground, fire blocking, and header spans.
8. Insulation & Poly
All Heated Areas
Thermal batts and 6-mil poly sealed with acoustical caulking.Continuous vapour barrier seal, insulation R-values, and acoustic batts in suite ceilings.
9. Fire Separations Drywall
Suites & Garages
Drywall hung on shared walls/ceilings, prior to taping.5/8″ Type X drywall fastener spacing (7″–8″ o.c.), resilient channels, and intumescent fire stopping.
10. Final Plumbing & Building
Final Sign-Off
All fixtures operational, smoke alarms working, handrails set.Egress window openings, bedroom doors, smoke/CO alarms, handrails, and final permit closure.

Project Roadmap & Scope of Work

Select a phase below to jump to the details

  1. 1
    Groundwork & Foundation Tie-Ins (Additions Only)
  2. 2
    Plumbing Rough-In, DWV Pressure Tests & Gas
  3. 3
    Structural Framing & Bearing Wall Beam Load Transfers
  4. 4
    Thermal Insulation, Poly & Secondary Suite Fire Drywall
  5. 5
    Final Trade Sign-Offs, Life Safety & Permit Closure

Renovating an existing home or expanding its footprint with an addition requires navigating a tailored municipal inspection schedule. Because you are modifying an existing structure rather than building from raw dirt, municipal inspectors only inspect the new, altered, or exposed construction elements.

However, the golden rule of BC construction remains strictly enforced: no trade work may be concealed behind insulation, vapour barrier, or drywall until the municipal inspector has signed off on the approved paper set. Premature concealment results in immediate stop-work orders and invasive wall opening mandates.


Part 1: Detailed Breakdown of Each Inspection Stage

1. Foundation Dowel Tie-Ins & Setback Survey (Additions Only)

If your renovation includes a ground-floor room addition, bump-out, or secondary building footprint:

  • Footing Dowel Tie-Ins: Inspectors examine how the new foundation footings connect to the existing home. Structural drawings typically specify 15M or 20M rebar dowels drilled into existing concrete with high-strength structural epoxy (minimum 6″ to 8″ embedment depth).
  • BCLS Forms Survey: Before pouring concrete walls, a registered BC Land Surveyor (BCLS) must visit the site and produce a legal Building Location Survey. This certifies to the city plan examiner that the addition strictly obeys municipal front, side, and rear setback bylaws.
  • Perimeter Weeping Tile: 4″ perforated drain pipe laid with crushed washed rock and tied into the property's storm connection, protected by damp-proofing asphalt emulsion on new concrete.

2. Plumbing Rough-In & DWV Pressure Testing

Before calling your framing inspection, all new plumbing lines must be inspected under active test pressure:

  • Drain, Waste & Vent (DWV) Testing: The entire drainage stack must be filled with water to a minimum 10-foot head (or pressurized to 5 PSI with air) and held with zero pressure drop for at least 15 minutes while the inspector checks every solvent-welded ABS/PVC joint.
  • Potable Water Supply Testing: PEX or copper water lines must hold municipal line pressure (or 100 PSI air test).
  • Secondary Suite Plumbing: Verifying dedicated shutoff valves, trap primers on floor drains, pressure balance valves in shower fixtures, and proper vent pipe sizing through the roof.

3. Load-Bearing Wall Removals & Structural Framing Inspection

Removing interior walls to create an open-concept kitchen or Great Room is one of the most common residential renovation permits. The framing inspection verifies:

  • Engineered Beam Sizing: Confirming the installed beam matches the structural engineer's stamped drawings (e.g., multi-ply 1¾″ × 11⅞″ LVL beams, Glulam timbers, or structural steel I-beams).
  • Continuous Point-Load Transfers: The inspector will verify that weight from beam end-posts transfers directly down through the floor joists to solid blocking, basement posts, and reinforced concrete footings below. A beam that rests on unsupported subfloor joists will immediately fail inspection.
  • Simpson Strong-Tie Connectors: Checking joist hangers, post caps, hurricane ties, and structural screw patterns (SDS / SDWS screws) specified on the structural engineer's Schedule B.
  • Header Spans & Fire Blocking: Checking window/door header spans and fire stops installed at every vertical stud cavity transition between floors.

4. Thermal Insulation & Continuous Vapour Barrier

  • R-Value Compliance: Verifying friction-fit fiberglass/mineral wool batts or continuous spray foam insulation match the approved drawing energy notes (e.g., R-22 in 2×6 walls, R-28 in vaulted ceilings, R-50 in attics).
  • Continuous Air/Vapour Barrier: 6-mil polyethylene sheet must be fully sealed with continuous beads of acoustical sealant at top plates, bottom plates, and around window/door rough openings.
  • Vapour Barrier Hatches & Gaskets: Fire-rated electrical boxes on exterior walls must have poly gasket boot seals to prevent moisture and draft leakage.

5. The Critical Secondary Suite Check: Fire Separation Drywall

If legalizing a basement suite or garden suite, the Fire Separation Drywall Inspection is the single most critical life-safety milestone:

  • When to Call: Drywall must be hung on shared party walls, utility room enclosures, and suite ceilings, but MUST NOT BE TAPED, MUDDED, OR PAINTED.
  • What the Inspector Verifies:
    1. Drywall Type & Thickness: Verifying 5/8″ Type X firecode gypsum board (or double 1/2″ Type X drywall) as approved on the architectural permit plans.
    2. Screw Fastener Spacing: Fasteners must be driven 7″ to 8″ on center along all studs and resilient channels (RC-1). If screws are driven too deep and break the paper face, they do not count.
    3. Resilient Channel Spacing: Metal resilient channels installed at 16″ or 24″ on center across ceiling joists to achieve required STC 50+ acoustic privacy ratings.
    4. Intumescent Fire Stopping: Fire-rated acoustic caulking sealing all perimeter gaps, HVAC duct penetrations, and electrical junction boxes.

6. Final Building, Egress & Life Safety Clearances

Once all trades (plumbing, electrical, gas) have received final sign-offs, the municipal building inspector conducts the final inspection:

  • Bedroom Egress Windows: Every bedroom must have an unobstructed outside opening of at least 0.35 m² (3.77 sq. ft.) with no dimension less than 380mm (15 inches), a maximum sill height of 1.5m above the floor, and a minimum 550mm clearance in window wells.
  • Interconnected Smoke & Carbon Monoxide Alarms: Hardwired, interconnected alarms on all levels and inside all bedrooms. In secondary suites, a visual strobe and interconnected alarm between the main home and suite must sound simultaneously.
  • Stairs & Handrails: Continuous handrails between 865mm and 965mm height, with baluster spacing preventing a 100mm (4-inch) sphere from passing through.
  • Permit Closure: Passing this inspection closes the building permit and issues the formal completion notice or Occupancy Certificate.

Summary: Interior Remodels vs. Home Additions

Construction Check Interior Renovation / Basement Suite Home Addition / Second Storey
Excavation & Footing Depth Exempt (existing foundation remains) Mandatory: Minimum 18″ frost depth & bearing soil review.
BCLS Property Line Survey Exempt (interior walls don't affect setbacks) Mandatory: Legal survey proving addition complies with setback bylaws.
Rebar Dowels to Existing Concrete Exempt Mandatory: Epoxy dowels into existing foundation walls.
Plumbing DWV Pressure Test Mandatory: 10-ft head test on all new/moved pipes Mandatory: Full plumbing rough-in sign-off.
Bearing Wall Beam Inspection Mandatory for open-concept wall removals Mandatory for roof tie-ins and structural openings.
Rain Screen Mockup & Flashing Exempt (unless replacing exterior siding) Mandatory: 10mm cavity, sill pans, and bug screens.
Fire Drywall (Pre-Tape Mud) Mandatory for Suites: 5/8″ Type X drywall Mandatory for attached garages or multi-unit additions.
Final Trade & Building Sign-Off Mandatory: Closes building permit Mandatory: Releases Occupancy Certificate.

Top 5 Inspection Mistakes to Avoid on Renovation Sites

  1. Taping Drywall Before the Fire Inspection: If you mud or tape the joints before the inspector checks screw spacing and Type X stamps, the inspector will order you to strip or replace sheets.
  2. Missing Point Load Blocking in Crawlspaces: Installing a massive steel or LVL beam upstairs without adding concrete pad footings and posts in the basement crawlspace is an automatic failure.
  3. Calling Framing Before Plumbing & Electrical Sign-Offs: The building inspector will not look at wood framing until the plumbing DWV test and electrical rough-in permits are logged in the municipal database.
  4. Undersized Bedroom Egress Windows: Old basement windows often fail the 3.77 sq. ft. clear opening requirement. Always verify egress window dimensions on your approved drawings before framing.
  5. Leaving the Stamped Paper Plan Set Off-Site: If the inspector arrives and the full-size city-stamped drawing set is not on site, the inspection is cancelled on the spot, and a re-inspection fee will be charged.

Related Permitting & Inspection Guides

Canadian Blueprint Logo

Canadian Blueprint Inc.

BC Building Design & Permit Drawings

Published August 17, 2026

Back to Guides

Let's Get Started

Take the next step in your building journey with our specialized design and permit services.

Home Renovation
Additions & major upgrades
  • As-Built Measuring
  • Structural Changes
  • Secondary Suites
  • Basement Finishing
  • Kitchen & Bath Remodels
  • Exterior Facelifts
Learn More →
As-Built Measuring
Precise LiDAR scanning
  • 360° Walkthrough
  • Point Cloud Data
  • Digital Twin
  • AutoCAD Floor Plans
  • Elevation Drawings
  • Detailed Sections
Learn More →
