Navigating a municipal building permit in British Columbia can feel overwhelming when dealing with multiple municipal departments, digital file formatting rules, and technical bylaws. However, every municipality across Metro Vancouver and the Fraser Valley adheres to the same fundamental 8-stage approval pipeline.
Here is the complete step-by-step roadmap to how your building permit moves from initial design concepts to approved, stamped plans and final occupancy.
Step 1 — Prepare the Electronic Application Package
Before any municipal upload takes place, your project must be translated into an intake-ready electronic submission package. Municipalities will reject incomplete submissions at intake, resetting your waiting timeline.
A complete BC electronic permit package consists of four core elements:
- Municipal Application Forms & Checklists: The official permit application form signed by all registered property owners, accompanied by project-specific checklists (e.g., Single Family, Secondary Suite Legalization, Tenant Improvement, or Demolition).
- Current State of Title & Registered Charges: A fresh title search (dated within 30 to 90 days) along with registered covenants, easements, and statutory rights-of-way. Learn how to order these in our BC Land Title Search Guide.
- Historical Record Drawings: Archival blueprints from City archives establishing the legal baseline of the existing structure for renovations and additions. See our city-by-city Original Drawings Guides.
- Intake-Ready Architectural Drawing Package: Complete site plans, floor layouts, elevations, building cross-sections, structural layouts, and spatial separation calculations prepared by Canadian Blueprint.
[!IMPORTANT] Digital File Standards: Municipalities enforce strict criteria. Drawings must be exported as single multi-page vector PDFs, flattened to a single layer, named with standardized date conventions (e.g.,
YYYY MM DD Architectural Drawings.pdf), and sealed by registered professionals without "certifying" or locking the document so examiners can apply their digital approval stamps.

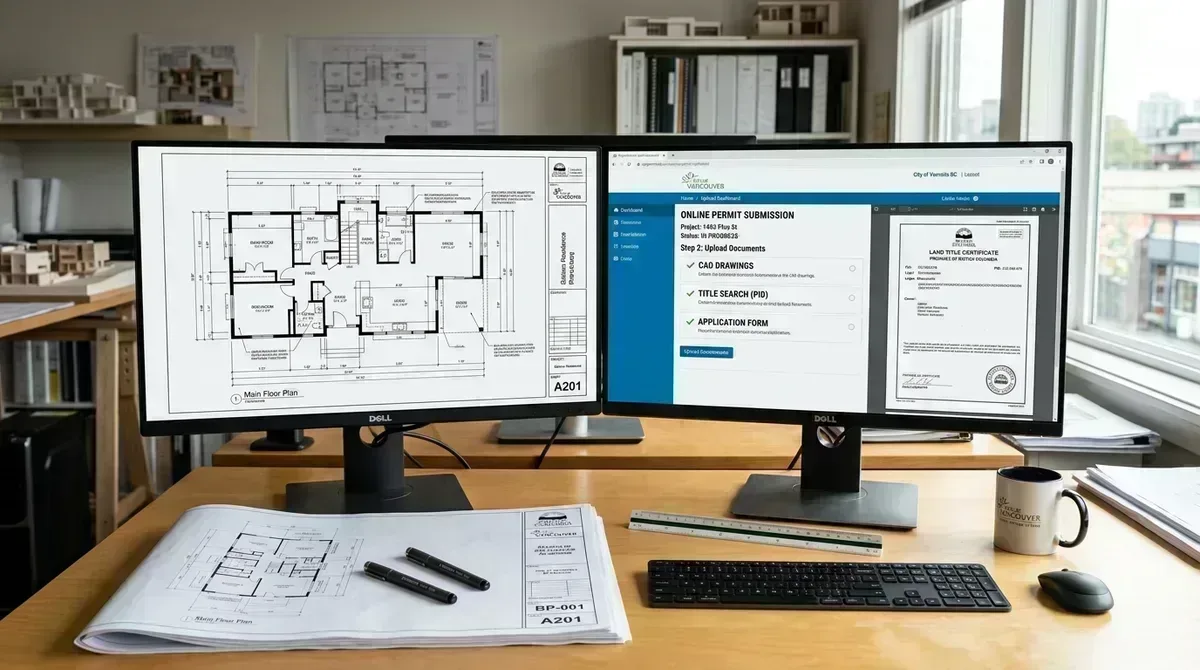

Step 2 — Submit Electronically via the Municipal Portal
Nearly all major BC municipalities have eliminated paper counter intake in favour of 24/7 digital permitting portals and secure file transfer systems:
- City of Vancouver: Submitted through the Vancouver ePermits POSSE Web Portal.
- City of Surrey: Submitted via the MySurrey Permitting Portal.
- City of Burnaby: Submitted through the Burnaby MyPermits EnerGov System.
- City of Richmond: Submitted via Richmond ePlan Digital Workspace.
- City of Coquitlam: Uploaded via Coquitlam QFile Secure Transfer.
During this step, the applicant logs into their personal municipal account, selects the permit classification, uploads the separate drawing and document PDFs, and submits the file for intake triage.
Step 3 — Preliminary Completeness Pre-Screening
Once your upload is received, municipal intake clerks perform an initial administrative pre-screening (typically taking 3 to 5 business days):
- Clerks verify that all mandatory forms, owner authorizations, and required schedules are attached.
- They check that drawing files adhere to PDF standards and sheet indexing rules.
- Tracking Number Assignment: Once accepted, your project is officially assigned a municipal file tracking number (e.g., BP Number or PAR Number — Permit Application Review).
If any document is missing or corrupted, the City will email a rejection notice requiring you to resubmit the missing items before the file proceeds.
Step 4 — Pay the Application Intake Fee
Following successful pre-screening, the City issues an electronic invoice for the Plan-Checking Intake Deposit:
- This intake fee covers the administrative and technical time spent by municipal plan examiners.
- It is calculated based on project scope, estimated construction value, or gross floor area (governed by each municipality's Fees and Charges Bylaw).
- Queue Entry: The moment payment is processed online via credit card or municipal e-billing, your project is placed in the active queue for technical plan checking.
Step 5 — Multi-Departmental Plan Check Review (The Deficiency Cycle)
This is the most critical phase of the permitting pipeline. Your drawing set is circulated concurrently across multiple municipal divisions:
- Planning & Zoning: Verifies property setbacks, allowable building height, Floor Area Ratio (FAR / FSR), lot coverage, and parking configurations.
- Building Code Examination: Reviews egress, staircase dimensions, fire-resistance ratings, window-to-wall spatial separations, and Step Code energy compliance under the BC Building Code.
- Structural & Geotechnical: Verifies load paths, foundation engineering, and Letters of Assurance (Schedules B & C-B).
- Plumbing, HVAC & Fire Protection: Checks drainage connections, water service sizing, ventilation calculations, and sprinkler layouts.
Plan checkers compile questions & code notes.
Email the comment letter directly to us.
We revise plans with revision clouds & code notes.
Updated PDF package uploaded for sign-off.
What Happens When You Receive a Deficiency List?

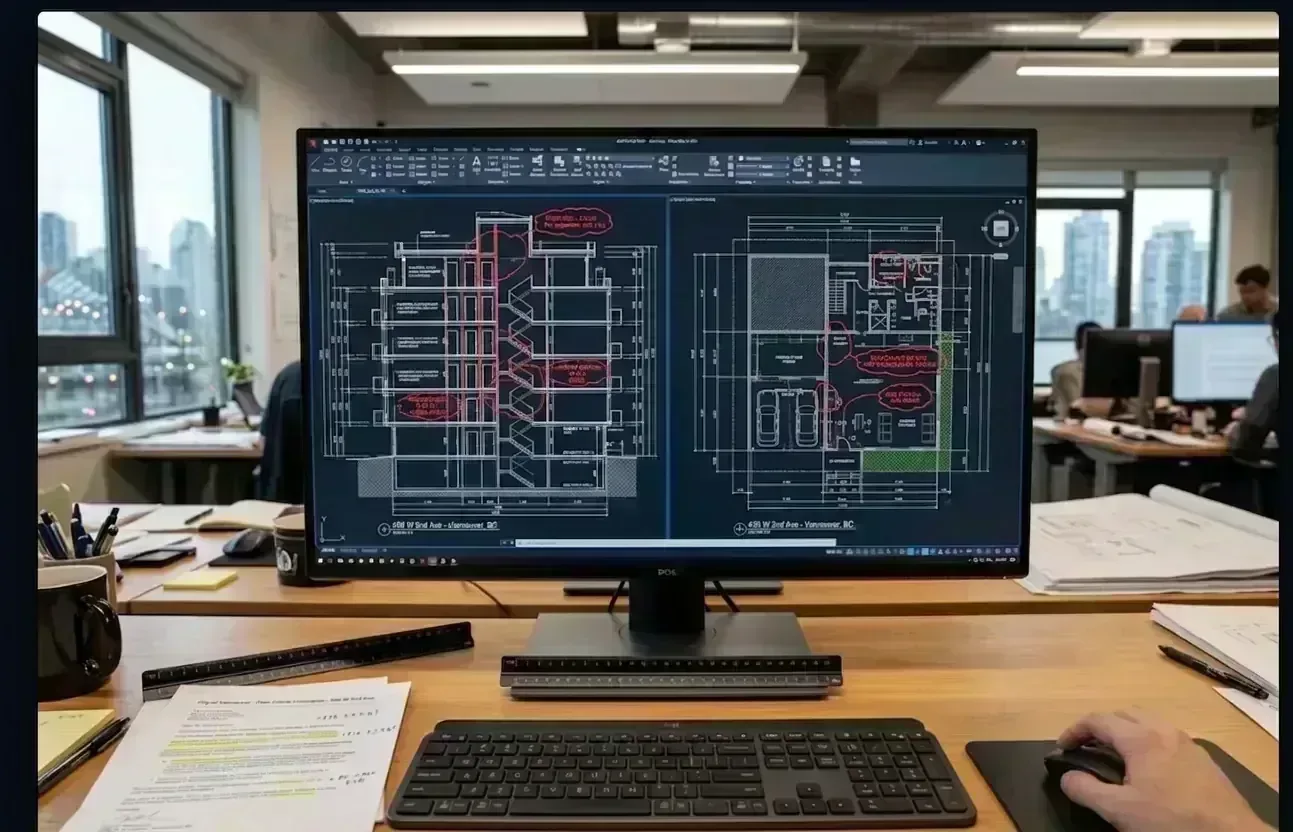

It is completely standard for plan checkers to issue a Plan Review Comment Letter or Deficiency List requesting clarifications or drawing modifications.
This is where Canadian Blueprint makes the process frictionless for you: You simply email the City's deficiency letter directly to us. Our drafting team reviews the examiners' notes, updates the CAD drawings to full compliance, and returns an updated, revision-clouded PDF package ready for re-upload.
Step 6 — Settle Remaining Permit Issuance Fees & Security Deposits
Once all reviewing departments sign off on the plans:
- The City prepares a final issuance invoice covering the remaining permit fees, plumbing/electrical trade fees, and any applicable Development Cost Charges (DCCs).
- Security & Damage Deposits: Most municipalities collect a refundable security deposit (typically $1,000 to $5,000) to protect municipal infrastructure (sidewalks, curbs, and storm connections) during construction.
- Once the final balance is paid, the permit is officially authorized for release.

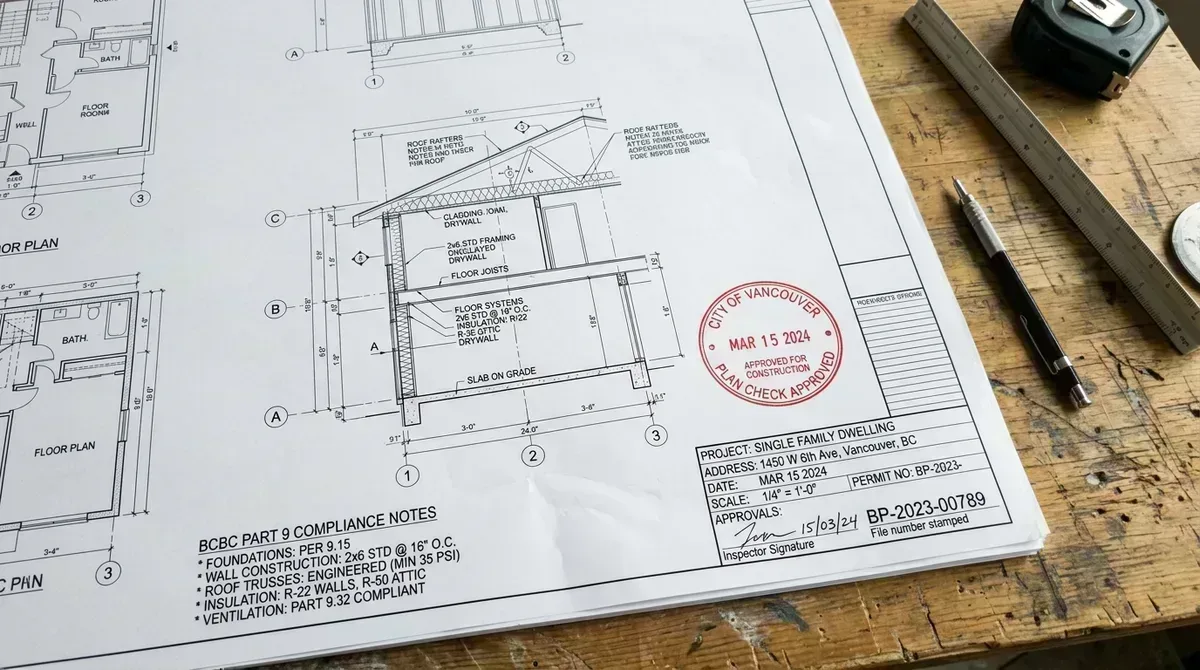

Step 7 — Release of City-Stamped Approved Drawings
Upon payment processing, the municipality releases your official Building Permit and City-Stamped Approved Drawings:
- You can download the digital, stamped PDF set directly from your online permit dashboard.
- The Mandatory Jobsite Paper Set: Even in a 100% digital submission system, municipal building bylaws mandate that you must print one full-size, to-scale paper copy (e.g., 30″ × 42″ or 24″ × 36″) of the City-stamped drawings and permit, and keep it accessible on the jobsite at all times for City Building Inspectors.
Step 8 — Mandatory On-Site Inspections & Occupancy
Receiving your Building Permit authorizes you to begin construction, but work must be inspected at sequential intervals before concealing any trades.
Construction inspections follow a strict hierarchy:
- Sub-Slab & Foundations: Excavation, footings, foundation forms & survey, perimeter drain tile, and under-slab poly insulation.
- Building Envelope: Exterior wall sheathing, rain screen drainage plane mockups, and stucco wire/scratch coats.
- Rough-In Trades & Framing: Rough-in plumbing (DWV & water line pressure testing), mechanical ducting, and structural framing.
- Insulation & Fire Separations: Insulation, continuous 6-mil vapour barrier, and fire-rated drywall assemblies.
- Energy Testing & Final Occupancy: Mid-construction and post-construction blower door airtightness testing, final trade inspections, and issuance of the Occupancy Certificate.
For project-specific inspection schedules, read our dedicated guides for New Build Inspections, Renovation & Addition Inspections, and Commercial TI Inspections.
Division of Work: What We Handle vs. What You Do
Canadian Blueprint structures the entire permitting pipeline so you never have to navigate technical drafting guidelines or complex CAD revisions alone:
| Task Area | Canadian Blueprint | Property Owner / Client |
|---|---|---|
| Design & Drafting | Prepares 100% compliant architectural drawing sets meeting BC Building Code and local zoning bylaws. | Approves floor plans, elevations, and design preferences. |
| Document Standards | Formats single-layer vector PDFs, applies correct title block margins, and coordinates digital seals. | Provides PID number, authorization signatures, and survey files. |
| Portal Submission | Delivers an intake-ready package organized for fast portal upload. | Uploads package to municipal portal and pays city fee invoices. |
| Deficiency Cycles | Reviews plan checker comment letters and updates CAD files rapidly. | Forwards municipal comment letters to Canadian Blueprint. |
| Site Execution | Coordinates structural revisions if site framing changes occur. | Prints stamped set for the site and books sequential trade inspections. |
Ready to Start Your Building Permit Application?
Whether you are designing a custom home, planning a major residential renovation, legalizing a basement suite, or completing a commercial tenant improvement, Canadian Blueprint delivers permit-ready drawing packages engineered for smooth municipal approval across British Columbia.
